Acid Plant Database January 4, 2011
| Owner | Minera y Metalurgica del Boleo S.A. |
|
| Location | East coast of the Baja Peninsula near Santa Rosalia, Baja Sur, Mexico | |
| Background | Company is controlled by Baja Mining Corporation | |
| Website | www.bajamining.com | |
| Plant | El Boleo | |
| Coordinates* | - | |
| Type of Plant | Sulphur Burning | |
| Gas Source | Sulphur | |
| Plant Capacity | 2400 MTPD | |
| SA/DA | DA | |
| Status | Engineering | |
| Year Built | 2010 | |
| Technology | MECS, Inc. | |
| Contractor | SNC Lavalin Engineers and Constructors | |
| Remarks | HRS and
Turbogenerator Reported Capital Cost: $120 million |
|

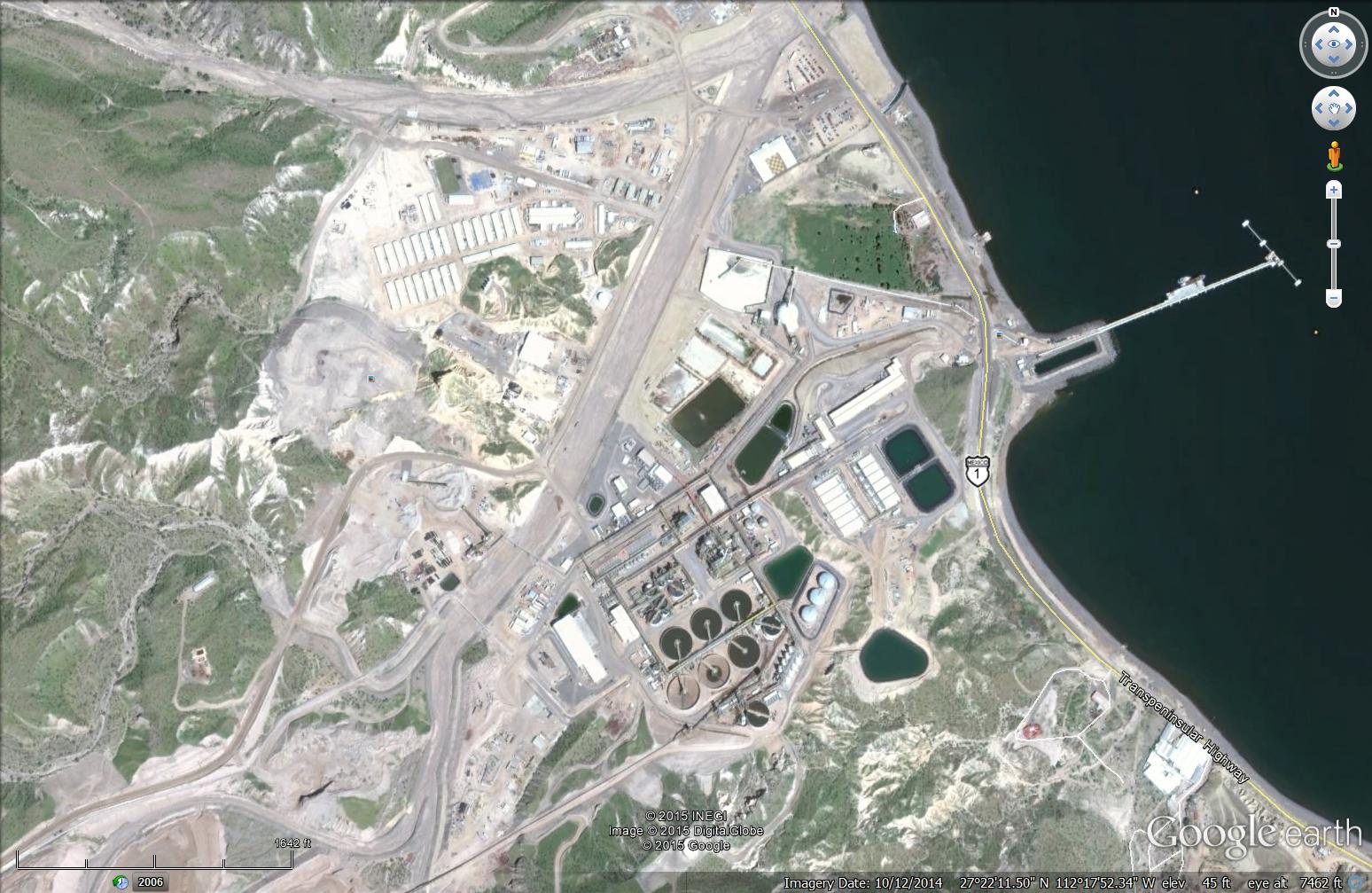

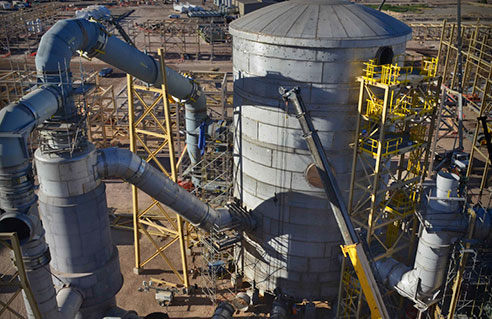

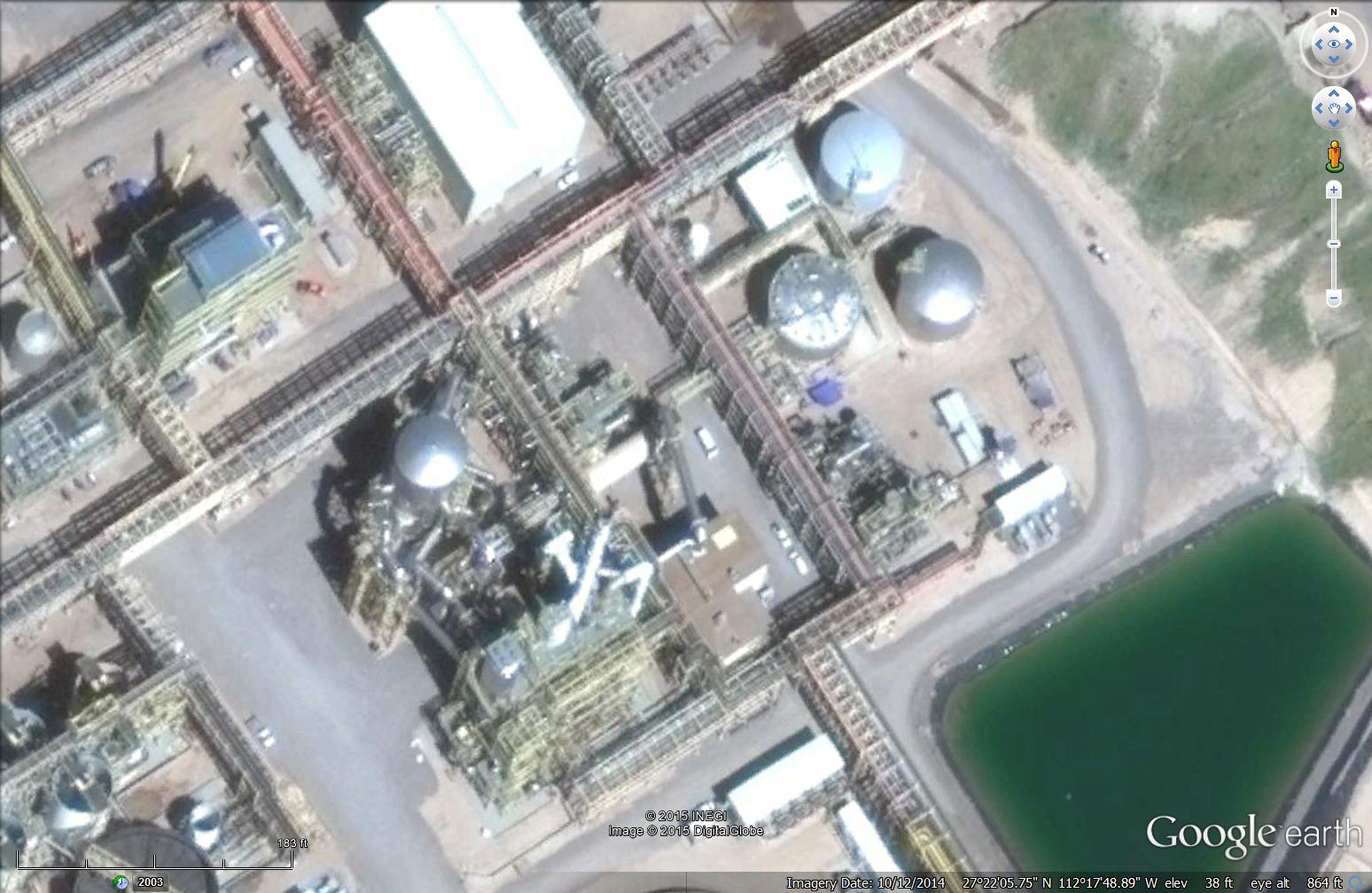

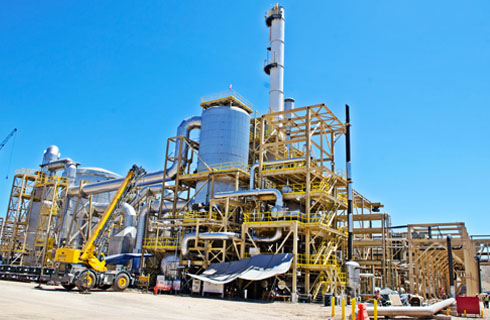

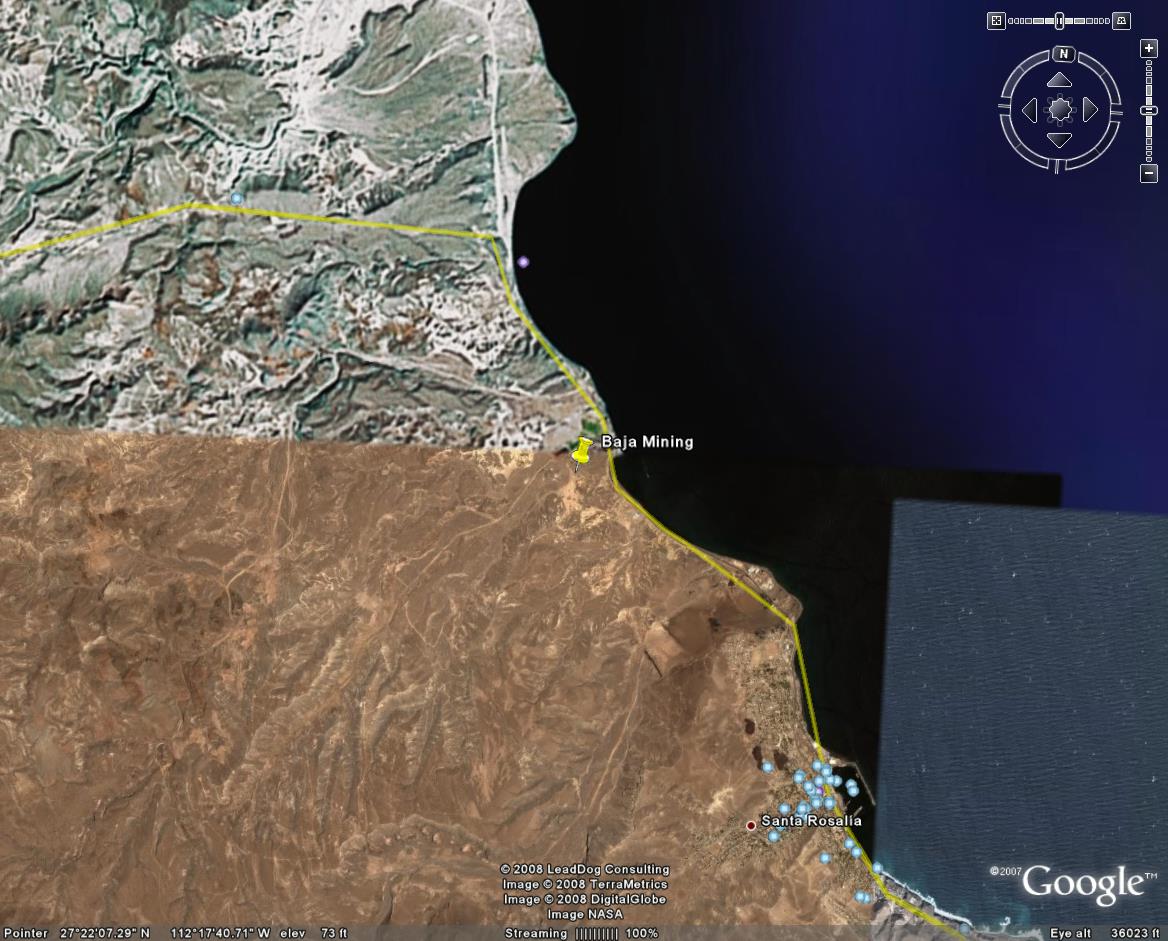

| Pictures | ![]() |
|
| General | The Acid Plant and Power Cogeneration (cogen) Plant are both critical path items in the construction schedule. Accordingly, to ensure their timely availability in 2009, the Company has placed the order for a 46 megawatt turbine and generator (TG) set which has been identified as the single longest lead item. The cost of this TG package is approximately US$10 million. Delivery is expected in 18-22 months. The Cogen Plant is an integral part of the acid plant and utilizes heat recovered from the burning of sulphur to generate power. When fully operational, it is anticipated that this facility will provide almost all of the power required for the mine and process plant. In addition, the Company has issued a “Letter of Award and Limited Authorization to Proceed” to SNC-Lavalin Engineers & Constructors Inc. for basic engineering and procurement services for the 2400 tonnes per day acid plant, complete with heat recovery system and the 46 MW turbo generator package. The parties are currently working on concluding a definitive agreement for all services; however work has commenced based on the award. | |
| References | - | |
| News | November 23, 2010
- Baja Mining Corp. ("Baja") is pleased to announce that its Boleo Project
is now fully funded for construction following Baja’s recently completed
US$858 Million project financing and C$184 Million bought deal financing.
“After signing the US$858 Million project financing facilities on September
28, 2010, the final component required to complete this milestone financing
was the equity raise of C$184 Million” said John Greenslade, President &
CEO, “Today, with over US$1 Billion raised, we are fully funded and ready to
move the Boleo Project to the construction phase with the goal of reaching
copper production in 2013”. Michael Shaw, Chief Operating Officer, stated, “We are a ‘shovel
ready’ project with mass earthworks ready to start within a month. Our most
significant long lead equipment has been fabricated or is in an advanced
state of fabrication. We have released our EPCM contractor and construction
activities are recommencing at site”. September 29, 2010
- Baja Mining Corp. (“Baja”) is pleased to announce that its 70% owned
project company, Minera y Metalurgica del Boleo S.A. de C.V. (“MMB”), has
finalized and signed US$858 million of financing facilities for the
construction and development of the Boleo project (the “Project”) located in
Baja California Sur, Mexico. The financing facilities comprise US$823
million of project financing facilities (the “Debt Facilities”) and a US$35
million equity cost overrun support facility (the “Equity Cost Overrun
Agreement”). “The closing of
the Boleo debt financing and the cost overrun funding are major milestones
for Baja and for the mining industry in Mexico,” said John Greenslade,
President & CEO. “The closing of these facilities is a testament to the
compelling economics of the project and to the strong effort of our team. It
also means full-scale construction activities at Boleo can commence
imminently.” Tom Ogryzlo, Chair of the Board, stated, “being associated with
the creation of the Boleo project has been one of the most memorable events
of my long career in the mining industry. I am very proud to be working with
such an outstanding management team.”
The US$823 million of Debt Facilities, representing the entire amount of
debt financing required to develop the Project, will be provided to MMB by
the Export-Import Bank of the United States (“EXIM”); Export Development
Canada (“EDC”); the Korea Development Bank (“KDB”); and by a group of
commercial banks comprised of Barclays Capital (the investment banking
division of Barclays Bank PLC), Standard Bank Plc, Standard Chartered Bank,
UniCredit Bank AG and WestLB AG (together, the “Commercial Lenders”). February 3, 2009 -
Following the previously announced slowdown in Project construction the
Company has been devoting significant time to progressing detailed
engineering. Work also continues at Boleo to complete certain infrastructure
on site, such as the phase 1 construction camp and desalination plant. The
Company has also commenced a capital and operating cost review, as it
believes that one positive outcome of the global financial crisis and the
related easing of the construction market, is the potential for a reduction
in capital and operating costs in the near term. The slowing of the original
construction schedule now enables the Company to take advantage of the
reduced cost environment. The re-costing estimate is being undertaken in
Vancouver together with the assistance of Baja's Korean partners. October 29, 2008 - Baja Mining advises that due to the current global financial crisis, it has elected to delay construction activities at the Boleo Project, Mexico. While project economics remain robust even at low metal prices, the impact of the current financial crisis on short term metal prices and hedging prices, coupled with an effective shutdown of the global bank syndication and equity markets, require Baja to revise its constuction schedule. On going baselining and engineering activities at Boleo will continue, as will completion of the Boleo construction camp and certain other on-site infrastructure activities. However, other activities at Boleo will be suspended until market conditions improve. |
|
MTPD - Metric Tonne per Day
MTPA - Metric Tonne per Annum
SA - Single Absorption
DA - Double Absorption
* Coordinates can be used to locate plant on Google Earth
